Welcome to WordPress. This is your first post. Edit or delete it, then start writing!
Category: Uncategorized
-
Eagle Creek Bluff Clubhome Association RESIDENTS!
10/13/25 Project update:
Roof replacements on all buildings have been completed. All remaining materials, bathrooms and equipment have been called in for pick up.
10/9/25 Project update:
Roof replacements on buildings 1-6, 8, 9, 10, 11, 16, 17, 18, 19, 21, 22, 23 and 24 are now complete! We are currently working on buildings 7 and 15 and expect to wrap those up by the end of the day. Tomorrow we will move onto buildings 13 and 14 and Sat. we will start building 12, weather permitting. If all goes as planned we should wrap up with all buildings by the end of day Sat. We will remove equipment, materials, etc. next week.
10/6/25 Project update:
Roof replacements on buildings 1-6, 10, 11, 16, 17, 18 and 21 are now complete! We are currently working on buildings 23 and 24 and expect to wrap those up by the end of the day. In addition, we will start building 22 today. Tomorrow we will move onto buildings 19 and 9, weather permitting. If all goes as planned we should wrap up by the end of the week.
10/3/25 Project update:
Roof replacements on buildings 1-6, 16 and 17 are now complete! We are currently working on buildings 18 and 10 and expect to wrap those up by the end of the day. We will then move onto buildings 11 and 21 tomorrow and buildings 24 and 22 on Mon. (weather permitting).
10/2/25 Project update:
Roof replacements on buildings 1-6 are now complete! We are currently working on buildings 16 and 17. We will then move onto buildings 18 and 10 tomorrow. We will plan to work on Sat. as well and will likely start buildings 11 and 21 (weather permitting).
10/1/25 Project update:
We are completed with roof replacements on buildings 1-4 and are currently working on buildings 5 and 6. We will then move onto buildings 16 and 17.
9/30/25 Project update:
We’re working through the first few buildings and are completed with roof replacements on buildings 1 and 2 and are currently working on buildings 3 and 4. We will then move onto buildings 5 and 6 tomorrow.
What to expect:
We expect each building to take approx. 1-2 days to complete. We will have 3 crews working onsite and each on different buildings. We believe we will wrap up with all roof replacements in 2-3 weeks, weather permitting.
There will be disruptions and required accommodations to be made by residents. We appreciate your patience throughout the project and your understanding as we work through repairs.
As with any large construction project, some issues are anticipated. Please report them to us as soon as possible so we can address them accordingly.
Here is the What To Expect information laid out in a singular document for print or convenience: WHAT TO EXPECT
Site Map + schedule:
You can download the map HERE
Vehicles * VERY IMPORTANT *
Have your vehicles off the driveway and moved out and away from your garage and building by 7:00 AM on the day(s) listed above and until your building has been completed to prevent damage to vehicles.
Suggestions to Ensure a Problem Free Roof
-
Remove patio furniture, grill and property from decks/patios as well as fragile items from walls, as these may incur damage during work. Contractor is NOT liable for such damages.
-
Please remove pet waste from your yard before the project starts to avoid messes on the roof and sidewalks, etc. as a result.
-
While we are working on your home, please close your window coverings during the day. This will help avoid any accidental embarrassments as the workers go up and down ladders to access the roof.
Landscaping
If there are any special or delicate plant or shrubs, please notify us of them before the job starts and we will protect them as best as possible.
Clean Up
One of the most important aspects of a project is keeping the area clean during the job. Here is how we strive to do this every day…
-
Clean your site during the day and at the end of the day.
-
Clean your lawn and site with our magnetic “nail-finder” to reduce chance of any nails being left in your lawn.
-
Keep our tools and materials neatly organized and out of the way.
Conditions beyond our control
Please be aware that despite our best efforts the following may occur during improvement projects, and are not the responsibility of the contractor:
-
Existing structural problems: Such as loose or cracked plaster and drywall, sagging rafters, nail-pops, bowed walls, previously rotted or damaged materials, etc.
-
Scheduling difficulties: We do our best to stay on schedule, but mother nature and other emergencies can lead to delays. We will do our best to limit delays.
Satellite Dish notice
Homeowners who have satellite dishes will be without service during the re-roofing of your building. Capital Construction will reset the dish to the best of their ability, however if you experience issues please notify your service provider to schedule a service call for recalibration. Here is the offical Satellite Dish Notice.
If you DO NOT want your satellite dish re-installed once the roof replacement is completed, please contact Josie Flicek before the start of your building by emailing josie.f@capitalmn.com so it can be properly disposed of.
Questions
Please do not hesitate to contact Stronghouse Solutions with any questions or concerns via the website form on this page, or by contacting your account manager, Josie Flicek, at 952.222.4004 or at josie.f@capitalmn.com. Please leave your address, name, email and phone number when you contact us. Thank you!
-
-

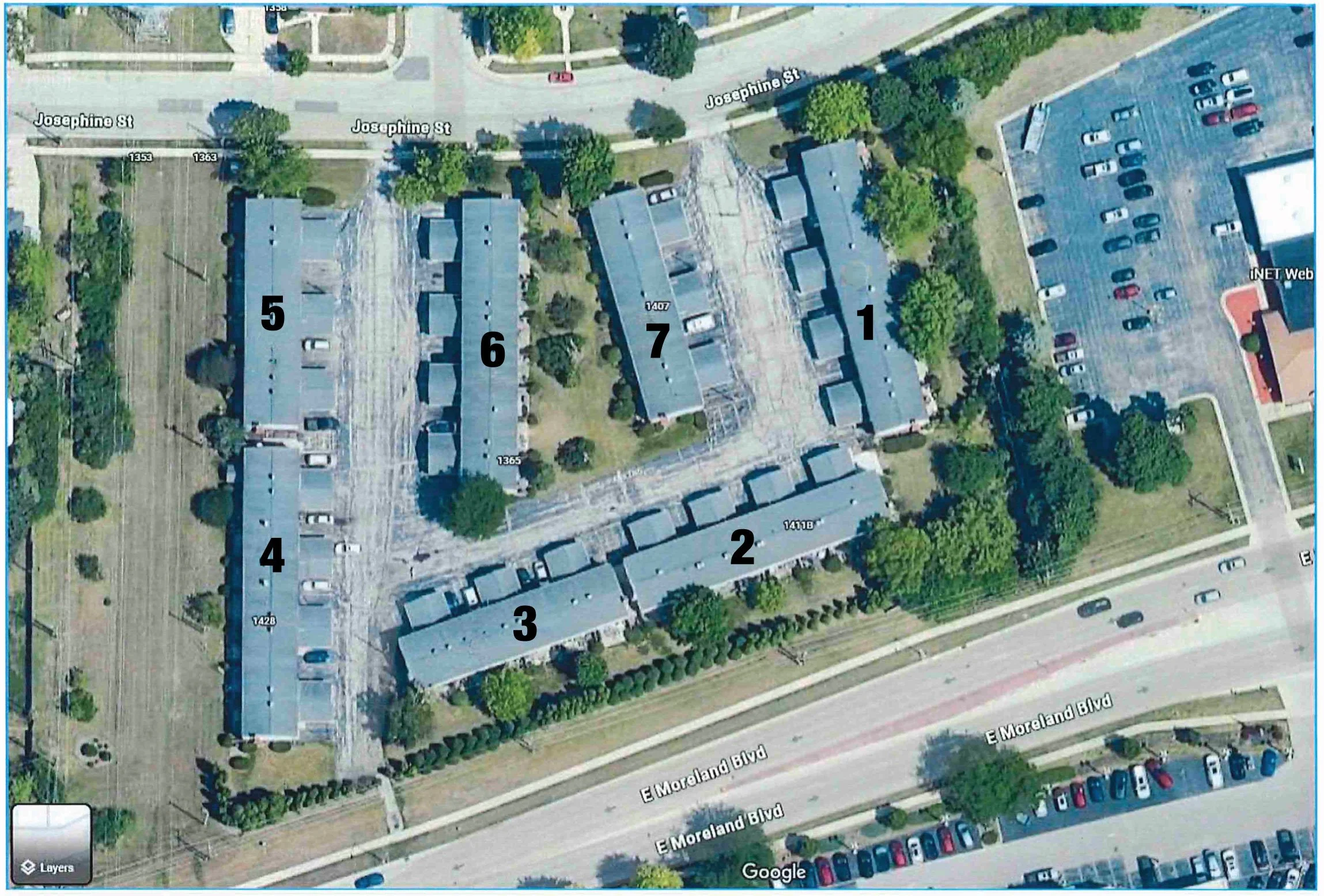

WELCOME Cardinal Green Association RESIDENTS!
Progress update: 8.25.25
Roof replacements are all complete! Extra materials and bathrooms, etc. will be removed from the site this week sometime.
Progress update: 8.21.25
Roof replacements are continuing strong! We’ve completed buildings 1-4 and are currently working on building 5. We expect to finish building 5 today as well as roof load materials onto buildings 6 and 7. We plan to tear off buildings 6 and 7 tomorrow and will finish those two final buildings by end of day Sat., weather permitting. That will wrap up the project! Extra materials and bathrooms, etc. will be removed from the site next week sometime.
Progress update: 8.20.25
Roof replacements are going strong! We’ve completed buildings 1 and 2 are currently working on buildings 3 and 4. We expect to finish building 3 today and hope to also finish building 4 today. We will then move onto buildings 5 and 6 tomorrow, weather permitting.
Progress update: 8.19.25
Roof replacements are underway! We’ve completed building 1 and are currently working on buildings 2 and 3. We expect to finish building 2 today and hope to be about 50% done with building 3. We will then move onto buildings 4 and 5.
Parking:
We’ve worked with the Waukesha Police to arrange that from August 18th to August 29th, if residents can’t get back into their parking spots, they will not ticket Cardinal Green vehicles parked overnight on the street. All other posted parking signs still apply and must be followed.
What to expect:
Printable version of this page : What to Expect | Cardinal Green Association
We expect each building to take approx. 1-2 days to complete. We will have 2 crews working onsite and each on different buildings. We believe we will wrap up with all roof replacements in 1 week, again weather permitting.
There will be disruptions and required accommodations to be made by residents. We appreciate your patience throughout the project and your understanding as we work through repairs.
As with any large construction project, some issues are anticipated. Please report them to us as soon as possible so we can address accordingly. Please see the material delivery and roof load schedule below:
Monday 8/18 – Deliver and boom/load buildings 1-2
Tuesday 8/19 – Deliver and boom/load buildings 3-4
Wednesday 8/20 – Deliver and boom/load buildings 5-6
Thursday 8/21 – Deliver and boom/load building 7Below is a map of the work site:

Printable Map Vehicles * VERY IMPORTANT *
Have your vehicles off the driveway and moved out and away from your garage and building by 7:00 AM on the day(s) listed above to prevent damage to vehicles.
Suggestions to Ensure a Problem Free Roof
-
Remove patio furniture, grill and property from decks/patios as well as fragile items from walls, as these may incur damage during work. Contractor is NOT liable for such damages.
-
Please remove pet waste from your yard before the project starts to avoid messes on the roof and sidewalks, etc. as a result.
-
While we are working on your home, please close your window coverings during the day. This will help avoid any accidental embarrassments as the workers go up and down ladders to access the roof.
Landscaping
If there are any special or delicate plant or shrubs, please notify us of them before the job starts and we will protect them as best as possible.
Clean Up
One of the most important aspects of a project is keeping the area clean during the job. Here is how we strive to do this every day…
-
Clean your site during the day and at the end of the day.
-
Clean your lawn and site with our magnetic “nail-finder” to reduce chance of any nails being left in your lawn.
-
Keep our tools and materials neatly organized and out of the way.
Conditions beyond our control
Please be aware that despite our best efforts the following may occur during improvement projects, and are not the responsibility of the contractor:
-
Existing structural problems: Such as loose or cracked plaster and drywall, sagging rafters, nail-pops, bowed walls, previously rotted or damaged materials, etc.
-
Scheduling difficulties: We do our best to stay on schedule, but mother nature and other emergencies can lead to delays. We will do our best to limit delays.
Satellite Dish notice
Homeowners who have satellite dishes will be without service during the re-roofing of your building. Stronghouse Solutions/Capital Construction will reset the dish to the best of their ability, however if you experience issues please notify your service provider to schedule a service call for recalibration.
If you DO NOT want your satellite dish re-installed once the roof replacement is completed, please contact Josie Flicek before the start of your building by emailing josief@poweredbystronghouse.com so it can be properly disposed of.
Also here is a printable version of the Satellite Dish Notice
Questions
Please do not hesitate to contact Stronghouse Solutions with any questions or concerns via the website form on this page, or by contacting your account manager, Josie Flicek, at 866.989.6641 or at jflicek@stronghousebrands.com. Please let me know your address, name, email and phone number when you contact us. Thank you!
-
-

Welcome glen eden Residents!
UPDATES:
06/27
All Buildings are complete! We are currently working on scheduling punch list items and extra material/equipment pick up and expect these to be removed this week.
06/25
Buildings 1-23 are complete. We are currently working on building 25 and expect to finish that this morning. We will finish with the final building, 24, on Thurs./Fri., weather permitting.
06/23
Buildings 1-23 are complete. We are currently working on building 26 and expect to move onto building 25 tomorrow. We should wrap up building 25 tomorrow and then will finish with the final building, 24, on Wed., weather permitting.
06/19
Buildings 1-21 are complete. We are currently working on building 22 and expect to move onto building 23 tomorrow. We should wrap up buildings 22 and 23 before the weekend and due to heat do not intend to work on Sat. or Sun.
06/17
Buildings 1-20 are complete (with the exception of some ridge on building 16 which we’re waiting on from the supplier/Brava). We are currently working on building 21 and expect to continue on that building tomorrow as well, weather permitting.
06/13
Buildings 1-18 are complete (with the exception of some ridge on building 16 which we’re waiting on from the supplier/Brava). We are currently working on building 19 and expect to wrap that up tomorrow or Mon., weather permitting. We will then move onto building 20. We are NOT working today and didn’t work yesterday due to rain and don’t intend to work Sunday (Father’s Day).
06/10
Buildings 1-17 are complete (with the exception of some ridge on building 16 which we’re waiting on from the supplier/Brava). We are currently working on building 18 and expect to wrap that up today or tomorrow. We will then move onto building 19 tomorrow or Thurs., weather permitting.
06/06
Buildings 1-15 are complete and building 16 will finish today as well. We will move onto building 17 and 18 next week. We will NOT be working this weekend and will return on Monday, weather permitting.
06/02
Buildings 1-13 are complete and building 14 will finish today as well. We will move onto building 15 today and then building 16 will follow. With rain forecasted tomorrow we may not be onsite. As a result of the rain, we have decided to postpone the Taco Truck event and that will now be held on June 24th, weather permitting and while supplies last.
05/30
Buildings 1-10 are complete and building 11 will finish today as well. We will also move onto building 12 today and then building 13 will follow. We hope to finish 12 and 13 over the weekend. We WILL be working this weekend on both Sat. and Sun. to catch up from the weather we’ve had recently. We expect to start building 14 on Monday.
05/28
Buildings 1-9 are complete. We started building 10 as well and expect to finish that building today or early tomorrow (weather permitting). We will then move onto building 11 tomorrow and hope to wrap that one up Fri. We then will move to buildings 12 and 13 and hope to finish those over the weekend. We WILL be working this weekend on both Sat. and Sun. to catch up from the weather we’ve had recently.
05/27
Buildings 1-8 are complete (with the exception of some ridge cap which wasn’t delivered and we’re waiting on). We started building 9 as well and expect to finish that building today or early tomorrow (weather permitting). We will then move onto buildings 10 and 11 expecting to start Wed./Thurs.
05/23
REVISED: Buildings 1-7 are complete (with the exception of some ridge cap which wasn’t delivered and we’re waiting on). We started building 8 yesterday and expect to finish that building today. We will then move onto building 9 on Tues. With rain suspected on Monday we didn’t want to risk leaving building 9 open and unfinished. No work will be taking place over the weekend so residents can enjoy the holiday.
05/23
Buildings 1-7 are complete (with the exception of some ridge cap which wasn’t delivered and we’re waiting on). We started building 8 yesterday and expect to finish that building today. We will then move onto building 9 on Sat., however should finish that building Sat. as well. No work will be taking place Sunday or Monday so residents can enjoy the holiday.
05/19
Buildings 1-6 are complete (with the exception of some ridge cap which wasn’t delivered and we’re waiting on). We started building 7 today and expect to finish that building as weather permits. We will then move onto building 8, however rain is expected this afternoon and most of tomorrow as well as Wed. so we likely won’t be back onsite until Thur.
05/09
Buildings 1, 2 and 3 are complete (with the exception of some ridge cap which wasn’t delivered and we’re waiting on). We started building 4 yesterday and expect to finish that building today, weather permitting. We will then move onto building 5, however rain is expected this afternoon and most of tomorrow so we likely won’t be back onsite until Sat.
05/08
Buildings 1 and 2 are complete (with the exception of some ridge cap which wasn’t delivered and we’re waiting on). We started building 3 yesterday and expect to finish that building tomorrow. We will then move over to building 4.
05/07
We’re off to a great start and the weather couldn’t be better! Building 1 is complete (with the exception of some ridge cap which wasn’t delivered) and we’re well on our way with roof replacement on building 2. We appreciate your flexibility with parking and your cooperation with the crews, excess noise and construction. We will continue working through building 2 and expect to finish it later this week. Building 3 will be next in line and notices will be posted approx. 1 day in advance of starting on each building.
04/16
We hope you’re doing well. We have a few important updates to share regarding the community that we’d like you to be aware of. First, please note there are some changes to parking in certain areas due to ongoing maintenance. We ask for your cooperation and appreciate your flexibility as we work to improve the property.
There is also a temporary satellite dish outage affecting some buildings. We’re actively working with our service provider to restore functionality as soon as possible and will keep you informed as we receive updates.
We’ve provided a map that outlines which buildings are scheduled for upcoming work, so you can stay informed about what’s happening near your unit. Alongside that, you’ll find updates on landscaping and general cleanup efforts around the property as we continue to enhance the look and feel of our community.
Additionally, we’re going to have a taco truck on site, enjoy a free taco on us! Info is in the link below
All related documents, including the building map, maintenance schedules, and additional details, can be accessed using the links below.
WHAT TO EXPECT | CONSTRUCTION SITE MAP | SATELLITE DISH NOTICE | TACO TRUCK INFO
Thank you for your continued support and patience. If you have any questions, please don’t hesitate to reach out to josie.f@capitalmn.com
Warm regards,
Capital Construction -

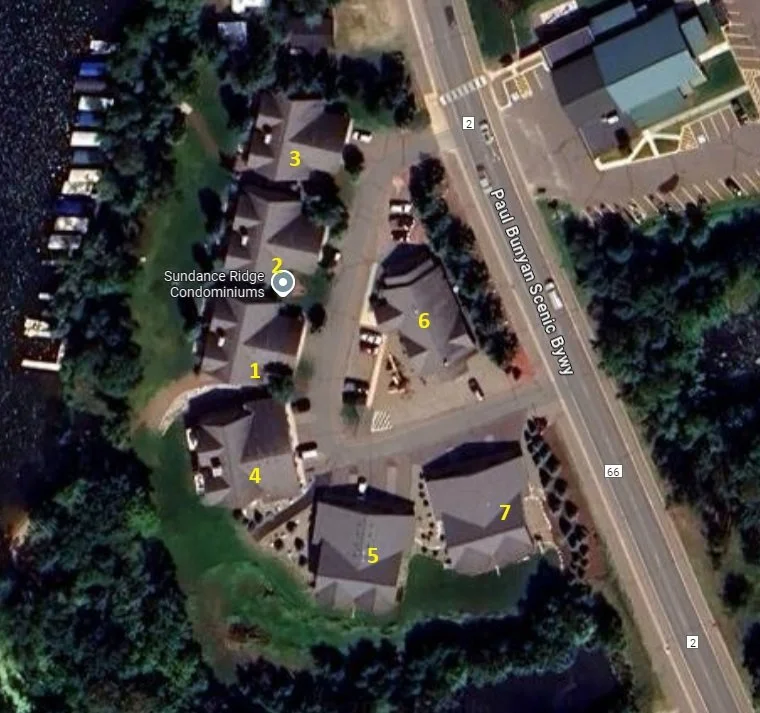

Welcome Sundance Ridge Residents

Sundance Ridge Condominiums 9/13
Hello! The roofing project is complete! Check back for some ‘after’ photos next week. Thank you all for your cooperation during this week and enjoy your weekend!
9/12
Day 4 went just as planned! Building 2 was finished today and building 1 will be finished tomorrow. Thanks again for being mindful of our crews and letting them do their thing to get the roofs looking great! Let us know if you have any questions or concerns, and thank you for allowing Capital Construction to be your contractor of choice!
9/11
Greetings Sundance residents! We are on track to hopefully complete the project by end of day Friday. Today the crews wrapped up building 3. Building 4 will be complete tomorrow and they will move on to 1 and 2 following. Thank you all for your cooperation during this project!
9/10
Day 2 was a success! Buildings 7, 6 and 5 are complete! Building 4 has begun tear off and will be wrapped up tomorrow, Wednesday, 9/11. Buildings 1, 2, and 3 are on track to wrap up Friday if all goes as planned! We’ll keep you posted here and as always, thank you for your continued cooperation while we wrap up the roofing project! Please do not hesitate to reach out if there are any questions or concerns.
9/9
Day one went great! The crews will wrap up buildings 6 and 7 Tuesday 9/10, and then will move on to 5 and 4. Please continue to be cautious around workers and buildings that are under construction for everyone’s safety. The dump trailers need to be parked in front of the buildings crews are working on and vehicles will need to be moved out of the way during that time. We appreciate your cooperation to keep the project moving.
Project start date:
Weather permitting your project is scheduled to begin Monday September 9th.
09/5
Hello Sundance!
We’re excited to get to work on the roofing project!
Please take a look at the information below. Thank you in advance for your cooperation with not parking in the drop zone areas for the short times we need to have product placed there.
Equipment delivery will be dropped between Friday 9/6 and Monday morning 9/9, it will be as far out of the way as possible.
Further Delivery Schedules are as follows:
*Monday 9/9 as early as possible – drop buildings 6 and 7.
Drop 1 will be in the parking space on the south end of the pool building.
*Monday (anytime) drop buildings 4 and 5
Drop 2 will be in the parking space on the SW corner of the pool building on the back side of the flagpole.
*Wednesday am – drop buildings 1-3
Drop 3 will be as far out of the way as possible on the north end of the pool building.
Stay tuned for updates!

We expect to begin the project, weather permitting, on Monday, September 9.
We will have 2 crews working onsite with a goal to complete two buildings per 1.5 days, weather permitting. The entire project should wrap up in 1 – 1.5 weeks.Working hours are Monday – Saturday, 7:00am-dusk.
Please look over this information regarding pre-project measures which should be taken, information on what to expect throughout the project, and a map of the building order in which the roof replacements will be completed.
Please contact us should you have any questions or concerns.
We look forward to servicing your community and thank you in advance for your patience throughout the project as well as your cooperation with the relative disruptions as a result!
WHAT TO EXPECT
There will be disruptions and required accommodations to be made by residents. We appreciate your patience throughout the project and your understanding as we work through repairs.
As with any large construction project, some issues are anticipated. Please report them to us as soon as possible so we can address accordingly.
VEHICLES
VERY IMPORTANT: Have your vehicles off the driveway and moved away from your building by 7:00 AM on the day(s) listed above to prevent damage to vehicles.
Satellite dishes
If you have a satellite dish on your roof please contact us ahead of time at tina.k@capitalmn.com. It will be removed during the work on your roof and you will need to contact your provider to have re-installed. If it is no longer in use we will dispose of it at your request.
SUGGESTIONS TO ENSURE A PROBLEM FREE ROOF
-
Remove patio furniture, grill and property from decks/patios as well as fragile items from walls, as these may incur damage during work. Contractor is NOT liable for such damages.
-
All pet waste needs to be removed before the project starts. Messes as a result are not the responsibility of the contractor.
-
While we are working on your home, please close your window coverings during the day. This will help avoid any accidental embarrassments as the workers go up and down ladders to access the roof.
LANDSCAPING
If there are any special or delicate plant or shrubs, please notify us of them before the job starts and we will protect them as best as possible.
CLEAN UP
One of the most important aspects of a project is keeping the area clean during the job. Here is how we strive to do this every day…
-
Clean your site during the day and at the end of the day.
-
Clean your lawn and site with our magnetic “nail-finder” to reduce chance of any nails being left in your lawn.
-
Keep our tools and materials neatly organized and out of the way.
CONDITIONS BEYOND OUR CONTROL
Please be aware that despite our best efforts the following may occur during improvement projects, and are not the responsibility of the contractor:
-
Existing structural problems: Such as loose or cracked plaster and drywall, sagging rafters, nail-pops, bowed walls, previously rotted or damaged materials, etc.
-
Scheduling difficulties: We do our best to stay on schedule, but mother nature and other emergencies can lead to delays. We will do our best to limit delays.
QUESTIONS?
Please do not hesitate to contact Capital Construction LLC with any questions or concerns via the website form on this page, or by contacting our Director of Multifamily Operations Derek Muelken directly at (952) 222-4004 or at info@capitalmn.com. Please leave your address, name, email and phone number when you contact us. Thank you!
-
-

Welcome Carriage Wood Residents

Project Start date: Weather permitting your project is scheduled to begin August 19th.
9/11
GOOD MORNING Carriage Wood residents. Today starts the gutters and the last trade to be completed for your exterior project. We will be starting at building “1” and working our way through wrapping up by Friday. Fascia and cap metal will continue to be done thorugh Friday as well.
Material will begin to be picked up starting Friday so all parking spaces can be clear.
A huge thank you to all of you for being so patient throughout this project. The transformation has been night and day! Your HOA board has done a tremendous job with selection of the projects, colors and for giving Capital the opportunity to serve you. Have a fantastic week!
9/10
We are on track to wrap up everything by this Friday. Building “6” will be done today and building “7” is halfway done
The fascia, siders edge and divider wall wraps will be all completed by Friday.
9/4
Building “1” is done and ready for gutter installation
Building “2” will start on the facia today
Building “3” completed and ready for facia
Building “4” will be very close to being completed today on siding
Building “5” started tear off yesterday for siding along with building “6”
8/30
Buildings 1-6 are complete with roofs.
Buildings 1,2,and 3 are being sided.
#1 siding will be finished Friday.
#2 siding will be finished Sat.
#3 siding will be finished Tues.
#4 siding will start Sat.
#5 siding will start Mon.8/28
Siding on buildings “1” “2” and “3” is underway and “1” “2” will finish this week. Building “4” will start Monday.
8/25
Roofing is complete on building “1” through “3” with “4” finishing up Monday 8/26. Buildings “1” and “2” are posted for siding to begin on Monday 8/26 with building “3” beginning Tuesday 8/27. We will have 3 siding crews following up the 2 roofing crews. We are hoping to have all the siding complete in 2 weeks weather permitting.
During this time parking will be at a premium given the number of crews onsite. Please be patient and if there is a need for access please reach out to my onsite project manager Luke.
Quick note: I have received a few concerns regarding nails and debris. Understand several thousand nails are being removed from your roof and siding. We do the best we can with several nail sweeps to get what we can. There is responsibility on every homeowner to stay aware that not all nails will be collected and to be understanding of this.
8/22
As of today we are completed with building “1” with building “2” being completed today. Building “3” has begun today with “4” potentially starting later today / tomorrow.
Our initial projections were each roof taking 2 to 2.5 days each. Due to some of the additions being made to the roofing system we are looking at 3 to 3.5 days per roof. Your building will be posted with a neon flyer when your building is up next. Appreciate everyone’s patience and understanding.
8/20
IMPORTANT: Please email luke.m@capitalmn.com with your unit number and if your satellite dish should be removed permanently or reinstalled. Many of you have reached out to your manager with this information however we would like to cross reference to ensure we are acting accordingly with your unit. Any other questions please contact Capitals office at 952-222-4004 and ask for Derek or Luke.
8/19
Good morning homeowners. Today your project has started and look forward to giving the property a facelift.
Couple notes:
-
Please ensure you move all outdoor furniture or items away from the building at least 6 feet to help prevent falling debris from damaging those items
-
Get your satellite info to your manager to pass along or find my onsite project manager Luke to advise if your dish can be tossed or needs to be reinstalled
Siding is scheduled to start next week with buildings 1 and 2. Below are the delivery dates for material.
Monday 8/26 – Deliver buildings 1 and 2
Monday 9/2 – Deliver buildings 3 and 4
Monday 9/9 – Deliver buildings 5-7
Material may be stored near your building and may sit for a few days until crews make it to your building.
Visible observation note: During the roofing project my crews will be removing the siders edge in preparation for the siding crew along with cutting siding along sidewalls. This is part of the project and is a measure taken to ensure additional waterproofing for the roof in preparation again for siding. This cutting of the siding is normal and part of the process and will be water tight prior to siding.

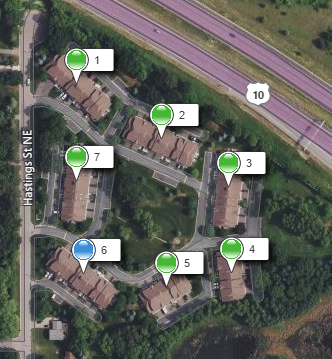

Building order:
The roofing portion of the project will begin on August 19th starting with buildings 1 and 2. We will have 2 crews working on 2 consecutive buildings at a time. Moving from buildings will be 3 and 4, 5 and 6 followed by 7. Due to the scope of work each building will take approximately 3 days weather permitting. During the roofing project we will begin the siding once we allow the roofers a chance to get ahead. An additional update will be sent out with this date along with a colored post on your garage door.
Bulding notes / delivery schedule:
Monday 8/19 – bring out and boom buildings 1-2
Wednesday 8/21- bring out buildings 3-4
Thursday 8/22 – boom buildings 3-4
Monday – 8/26 – bring out and boom buildings 5-6
Tuesday 8/27 – bring out building 7
Wednesday 8/28 – boom building 7PRODUCTS TO BE USED:
GAF Timberline ASII Charcoal
Exterior Portfolio D4 Metropolitan Gray
TIMING:
We expect to begin the project, weather permitting, on Monday, August 19th.
We will have 2 roofing crews working onsite and estimate each building to take approx. 3 days to complete, weather permitting. The entire roofing portion of the project should wrap up in about 2 weeks, weather permitting.
Working hours are Mon.-Sat., 7:00am-dusk.
Please look over the attached documents regarding pre-project measures which should be taken, information on what to expect throughout the project, and a map of the building order in which the roof replacements will be completed.
Please contact us should you have any questions or concerns.
We look forward to servicing your community and thank you in advance for your patience throughout the project as well as your cooperation with the relative disruptions as a result!
WHAT TO EXPECT
There will be disruptions and required accommodations to be made by residents. We appreciate your patience throughout the project and your understanding as we work through repairs.
As with any large construction project, some issues are anticipated. Please report them to us as soon as possible so we can address accordingly.
VEHICLES
VERY IMPORTANT: Have your vehicles off the driveway and moved away from your building by 7:00 AM on the day(s) listed above to prevent damage to vehicles.
SUGGESTIONS TO ENSURE A PROBLEM FREE ROOF
-
Remove patio furniture, grill and property from decks/patios as well as fragile items from walls, as these may incur damage during work. Contractor is NOT liable for such damages.
-
All pet waste needs to be removed before the project starts. Messes as a result are not the responsibility of the contractor.
-
While we are working on your home, please close your window coverings during the day. This will help avoid any accidental embarrassments as the workers go up and down ladders to access the roof.
LANDSCAPING
If there are any special or delicate plant or shrubs, please notify us of them before the job starts and we will protect them as best as possible.
CLEAN UP
One of the most important aspects of a project is keeping the area clean during the job. Here is how we strive to do this every day…
-
Clean your site during the day and at the end of the day.
-
Clean your lawn and site with our magnetic “nail-finder” to reduce chance of any nails being left in your lawn.
-
Keep our tools and materials neatly organized and out of the way.
CONDITIONS BEYOND OUR CONTROL
Please be aware that despite our best efforts the following may occur during improvement projects, and are not the responsibility of the contractor:
-
Existing structural problems: Such as loose or cracked plaster and drywall, sagging rafters, nail-pops, bowed walls, previously rotted or damaged materials, etc.
-
Scheduling difficulties: We do our best to stay on schedule, but mother nature and other emergencies can lead to delays. We will do our best to limit delays.
QUESTIONS?
Please do not hesitate to contact Capital Construction LLC with any questions or concerns via the website form on this page, or by contacting our Director of Multifamily Operations Derek Muelken directly at (952) 222-4004 or at info@capitalmn.com. Please leave your address, name, email and phone number when you contact us. Thank you!
-
-
Parkwood Summit Townhomes Association
Update 9/23/24:
Roof Replacements are complete and the remaining insurance claim repairs are scheduled to start next week, weather permitting.
Update 8/29/24:
We are underway with roof replacements. We are currently working on buildings 3 and 4 and should finish building 3 by mid day. Building four will wrap up today or tomorrow depending on when rain comes. We will then move onto building 5 tomorrow and expect all buildings roof replacements to wrap up by the end of day Sat. Upon completion of the roofs we will schedule pick up of any excess materials, conduct a final clean-up and order removal of onsite bathrooms which will likely take place next week sometime. We will then work on scheduling the remaining repairs such as fascia, siding and downspouts as approved within the claim.
Update 8/27/24:
We are underway with roof replacements. We are currently working on buildings 1 and 2 and will finish those buildings up today. We will be moving to buildings 3 and 4 likely tomorrow, weather permitting. The heat and rain yesterday set us back some, however we’re continuing to work through the repairs.
Roof Replacement Project Details:
In the coming weeks Capital Construction will be replacing the roofs throughout the association as a result of wind/hail damage.
What to expect:
We plan to start the roof replacement project on Mon., Aug. 26th, weather permitting. We anticipate each building will take approx. 1-2 days to complete. We will have 2 crews working onsite and each on different buildings. We believe we will wrap up with all roof replacements in 1 week, weather permitting.
There will be disruptions and required accommodations to be made by residents. We appreciate your patience throughout the project and your understanding as we work through repairs.
As with any large construction project, some issues are anticipated. Please report them to us as soon as possible so we can address accordingly.
A map of the community and order in which we expect to move through the project is copied below. We will begin with buildings 1 and 2, then move to buildings 3 and 4 and finish with building 5. The tentative schedule is noted below (which is weather permitting):
Mon. Aug. 26th-Start buildings 1 (5006 Ross Ln.) and 2 (5015 Ross Ln.)
Tues. Aug. 27th-Start buildings 3 (6001 Cyrus St.) and 4 (7000 Florida Ave.)
Wed./Thurs. Aug. 28th/29th-Start building 5 (7001 Rose Dr.)
Vehicles * VERY IMPORTANT *
Have your vehicles off the driveway and moved out and away from your garage and building by 7:00 AM on the day(s) listed above to prevent damage to vehicles and until your roof is complete.
Suggestions to Ensure a Problem Free Roof
-
Remove patio furniture, grill and property from decks/patios as well as fragile items from walls, as these may incur damage during work. Contractor is NOT liable for such damages.
-
Please remove pet waste from your yard before the project starts to avoid messes on the roof and sidewalks, etc. as a result.
-
While we are working on your home, please close your window coverings during the day. This will help avoid any accidental embarrassments as the workers go up and down ladders to access the roof.
Landscaping
If there are any special or delicate plant or shrubs, please notify us of them before the job starts and we will protect them as best as possible.
Clean Up
One of the most important aspects of a project is keeping the area clean during the job. Here is how we strive to do this every day…
-
Clean your site during the day and at the end of the day.
-
Clean your lawn and site with our magnetic “nail-finder” to reduce chance of any nails being left in your lawn.
-
Keep our tools and materials neatly organized and out of the way.
Conditions beyond our control
Please be aware that despite our best efforts the following may occur during improvement projects, and are not the responsibility of the contractor:
-
Existing structural problems: Such as loose or cracked plaster and drywall, sagging rafters, nail-pops, bowed walls, previously rotted or damaged materials, etc.
-
Scheduling difficulties: We do our best to stay on schedule, but mother nature and other emergencies can lead to delays. We will do our best to limit delays.
Satellite Dish notice
Homeowners who have satellite dishes will be without service during the re-roofing of your building. Capital Construction will reset the dish to the best of their ability,
however if you experience issues please notify your service provider to schedule a service call for recalibration.
If you DO NOT want your satellite dish re-installed once the roof replacement is completed, please contact Josie Flicek before the start of your building by emailing
josie.f@capitalmn.com so it can be properly disposed of.
Questions
Please do not hesitate to contact Capital Construction with any questions or concerns via the website form on this page, or by contacting your account manager, Josie Flicek, at 952.222.4004 or at josie.f@capitalmn.com. Please leave your address, name, email and phone number when you contact us. Thank you!
Additional Documents
-
-
Parkside Villas Project
siding, Screen, Garage door, Window and gutter Replacement Project Details:
Update 3/6/25:
We’re currently wrapping up a few siding repairs now that all window replacements have been completed along with all other insurance claim repairs! We expect to have the final items complete by early next week, weather permitting.
Update 2/4/25:
On-site Window Screening Pros and Overhead Door are continuing to schedule approved repairs and are contacting homeowners directly to schedule. Once these repairs are completed, along with the final few windows we’re waiting on and associated siding, the project will be complete!
Update 1/6/25:
On-site Window Screening Pros will be contacting homeowners (per the attached list) to begin scheduling pick up of the damaged window screens in the next 7-10 days.
They will pick them up and return them within 7-10 days.
They will plan to come in and remove the screens for them then will return them when repaired.
Please let me know if you have any questions.
Update 12/19/24:
Overhead Door will be starting garage door replacements for those included in the insurance claim/scope and will be contacting homeowners directly to schedule. I anticipate the first round of doors will be scheduled for the week of Jan. 3rd, weather permitting.
Please be advised that Stronghouse has partnered with Overhead Door to replace your garage door due to the hailstorm that took place in March. Overhead Door will be reaching out to you in the coming weeks to schedule a date and timeframe to complete the replacement. Sentry Management sent out information regarding how to prepare for the garage door replacement. Please review this information carefully and let me know if you have any questions. Thank you!
In addition, screen replacements are being scheduled and more information will be forthcoming on that. Window Screening Pros will be reaching out to individual homeowners directly with scheduling details as well. Please note the scope is limited to ONLY those screens included in the insurance scope.
Update 12/11/24:
While we’ve finished with the majority of the window and siding repairs/installations, we do have some items left to finish up….there are a handful of windows which are still on order and as soon as those come in we will schedule the install and return to complete the siding on those buildings. Those include:
Unit 1
Unit 27
Unit 31
Unit 87
As soon as materials are in we will return to complete this work. In addition, we will compile a punch list for items missed or requiring attention upon completion. We are aware of some issues which will require attention and will plan to address those.
Update 12/3/24: Window replacements schedule (tentative)
Tuesday 12/3
Unit 2
Unit 98
Unit 94
Unit 92Wednesday 12/4
Unit 88
Unit 84
Unit 82
Unit 57Thursday 12/5
Unit 72
Unit 70
Unit 48Friday 12/6
Unit 42
Unit 40
Unit 36
Unit 32Saturday 12/7
Unit 1
Unit 5
Unit 7Monday 12/9
Unit 9
Unit 11Tuesday 12/10
Remaining installationsAny failure to accommodate access inside of your home for window installations will result in no window replacements taking place and/or return trip charges being assessed for those who are not able to accommodate access.
Please note siding repairs will be resuming as well and understand that the above schedule is subject to change. We appreciate your flexibility as things change. Gutter and downspout replacements are complete. We’re also still working with insurance on the garage door replacements and will move those forward as soon as possible. Once siding repairs are complete we can work on scheduling the screen replacements.
Update 11/22/24
Window crew is moving along faster than we anticipated. We’re currently working on buildings 18 and 20 and will be starting bldgs. 16, 17 and 22 later today/tomorrow. In addition, we expect to move onto buildings 23, 24 and 25 tomorrow as well, weather permitting. Gutter replacements are moving along as well and we expect to complete all gutter and downspout replacements by the end of next week, weather permitting, however our siding and window installers won’t be returning until the week of Dec. 2nd to allow for time to be spent with family during the holiday. Dec. 2nd we expect to move onto window replacements for buildings 26 and 27 with buildings 28 and 29 to follow. We’re posting notices to the garage doors the day prior to installation. If you’re available and flexible it helps us continue to move through the project quickly. Thank you for your cooperation as the schedule changes frequently with homeowners being available or unavailable as we progress towards their buildings. We hope to have all window installations complete by the middle or end of the week of Dec. 9th. Please note there will be siding repairs, and some replacements, needed after window installations. This is expected and we’re planning to have the siding crews begin that work the week of Dec. 2nd as well.
Update 11/12/24
Siding crew is moving along. We’re currently working on buildings 19-21 and will be starting bldg. 25 later today. We expect to move onto buildings 26, 27 and 28 tomorrow, weather permitting. Gutter replacements will start later today or possibly tomorrow, weather permitting.
Documents: Window Schedule , What To Expect
Update 11/8/24
There shall be NO PARKING on the street in front of units 48-70 starting Monday at 7:00am. This is to accommodate the storage pods which will be delivered for window storage as installation approaches.
Update 11/7/24
Siding replacements on buildings 1 -4 are complete, in addition buildings 8-10 will be complete by the end of the day. We’re also currently working on siding on buildings 13 and 14. Tomorrow we will begin siding work on buildings 11, 15 and 16. Select buildings and/or elevations with windows are being skipped until the windows get installed. Going forward, we will require access inside of each unit prior to any siding replacements taking place. This is to ensure water to the exterior spigot(s) gets turned off. The plumbing inside of these buildings is very fragile and due to this we cannot take responsibility for any damage to plumbing or as a result of plumbing. In addition, the siding areas where windows will be replaced will be postponed until the window installations are complete.
WINDOWS: Window replacements will be started on Monday, Nov. 18th, weather permitting. More information will be forthcoming on what to expect. Storage PODS are being delivered next week Monday for window storage and will be placed on the street near UNITS 42 and 70 Green Park Ln.
GUTTERS/DOWNSPOUTS: Gutter and downspout replacements will be starting on Mon., Nov. 11th, weather permitting. We will be starting on buildings 1, 2 and 3 and expect to complete 3 buildings/day.
Update 11/4/24
Siding replacements on buildings 1 and 2 are complete and building 3 is partially complete. We will not be working on siding replacements today due to rain. Going forward, we will require access inside of each unit prior to any siding replacements taking place. This is to ensure water to the exterior spigot(s) gets turned off. The plumbing inside of these buildings is very fragile and due to this we cannot take responsibility for any damage to plumbing or as a result of plumbing. The next buildings to get started will be buildings 4, 6 and 8. In addition, the siding areas where windows will be replaced will be postponed until the window installations are complete.
WINDOWS: Window replacements will be started on Monday, Nov. 18th, weather permitting. More information will be forthcoming on what to expect.
GUTTERS/DOWNSPOUTS: Gutter and downspout replacements will be starting on Mon., Nov. 11th, weather permitting. We will be starting on buildings 1, 2 and 3 and expect to complete 3 buildings/day.
Update 10/21/24
Siding replacements are scheduled to start the week of Oct. 28th, weather permitting. Please see the information below regarding project details.
What To Expect Document: CLICK HERE

Update 7/30/24
All roofs have been completed. We are currently working on ordering materials for gutters/downspouts and siding and will send out information on that as we get closer to starting that work.
What to expect:
We expect each building to take approx. 1 day to complete. We will have 3 crews working onsite and each on different buildings. We expect EACH crew will be able to complete 1.5 TOWNHOME buildings per day and 3 SINGLE FAMILY HOMES per day, weather permitting. We believe we will wrap up with all roof replacements in 4-5 weeks, again weather permitting.
There will be disruptions and required accommodations to be made by residents. We appreciate your patience throughout the project and your understanding as we work through repairs.
As with any large construction project, some issues are anticipated. Please report them to us as soon as possible so we can address accordingly.
Vehicles * VERY IMPORTANT *
Have your vehicles off the driveway and moved out and away from your garage and building by 7:00 AM on the day(s) listed above to prevent damage to vehicles.
Suggestions to Ensure a Problem Free Roof
-
Remove patio furniture, grill and property from decks/patios as well as fragile items from walls, as these may incur damage during work. Contractor is NOT liable for such damages.
-
Please remove pet waste from your yard before the project starts to avoid messes on the roof and sidewalks, etc. as a result.
-
While we are working on your home, please close your window coverings during the day. This will help avoid any accidental embarrassments as the workers go up and down ladders to access the roof.
Landscaping
If there are any special or delicate plant or shrubs, please notify us of them before the job starts and we will protect them as best as possible.
Clean Up
One of the most important aspects of a project is keeping the area clean during the job. Here is how we strive to do this every day…
-
Clean your site during the day and at the end of the day.
-
Clean your lawn and site with our magnetic “nail-finder” to reduce chance of any nails being left in your lawn.
-
Keep our tools and materials neatly organized and out of the way.
Conditions beyond our control
Please be aware that despite our best efforts the following may occur during improvement projects, and are not the responsibility of the contractor:
-
Existing structural problems: Such as loose or cracked plaster and drywall, sagging rafters, nail-pops, bowed walls, previously rotted or damaged materials, etc.
-
Scheduling difficulties: We do our best to stay on schedule, but mother nature and other emergencies can lead to delays. We will do our best to limit delays.
Satellite Dish notice
Homeowners who have satellite dishes will be without service during the re-roofing of your building. Stronghouse Solutions will reset the dish to the best of their ability,
however if you experience issues please notify your service provider to schedule a
service call for recalibration.
If you DO NOT want your satellite dish re-installed once the roof replacement is completed, please contact Josie Flicek before the start of your building by emailing
josief@poweredbystronghouse.com so it can be properly disposed of.
Questions
Please do not hesitate to contact Stronghouse Solutions with any questions or concerns via the website form on this page, or by contacting your account manager, Josie Flicek, at 866.989.6641 or at josief@poweredbystronghouse.com. Please leave your address, name, email and phone number when you contact us. Thank you!
-
-

Stop Drafts and Boost Comfort: Why a Free Window Consultation Is the Smart Move
Are you thinking about upgrading your windows but unsure if it’s the right time? At Capital Construction, we believe that every homeowner deserves windows that look great, save money, and keep your home cozy year-round. That’s why we offer free consultations to help you make the best decision for your home. Not only do we love chatting with you about your home improvement goals, but we’re also here to make the process as smooth and rewarding as possible. Let’s dive into why getting new windows (especially Pella windows!) could be the best decision you’ll make this year.
First things first—why consider replacing your windows? If your windows are drafty, difficult to open, or just plain outdated, it might be time for an upgrade. Modern windows, like those from Pella, offer incredible energy efficiency, helping you save on those heating and cooling bills. They’re also built to last, with durable materials that withstand the elements while keeping your home stylish. Plus, new windows can drastically improve your home’s curb appeal and increase its value—a win-win whether you’re staying put or thinking about selling.
Not sure if your windows are ready for a replacement? Here’s a quick checklist to help you decide:
-
Drafts: Do you feel a breeze coming through even when your windows are shut?
-
Condensation: Are you noticing moisture or fog between the panes?
-
Functionality: Are your windows hard to open or close, or do they refuse to stay open?
-
Appearance: Do your windows look worn, cracked, or outdated?
-
Energy Bills: Have you noticed a steady increase in your energy costs without any other explanation?
If you checked off any of these items, it might be time to give your windows some attention. And when it comes to choosing the best, Pella windows are at the top of the list. With their innovative designs, superior insulation, and customizable options, they’re a perfect match for any home. At Capital Construction, we’re proud to partner with Pella because we know our customers deserve nothing but the best. Plus, our team makes the installation process a breeze—no stress, just beautiful results.
So why wait? Schedule your free consultation today and let Capital Construction guide you to the windows of your dreams. We’ll help you explore your options, answer all your questions, and show you how upgrading your windows can transform your home. With our friendly team and trusted Pella products, you’re in great hands. Let’s get started—your home deserves it!
-
-

The Durability Factor: Why Pella Windows Are Built to Last
When it comes to windows, durability isn’t just a luxury—it’s a necessity. Think about it: your windows are the first line of defense against unpredictable weather, daily wear, and that one rogue neighborhood kid practicing their fastball. With Pella windows, durability isn’t just a feature; it’s a promise.
Pella’s windows are engineered to handle whatever life (or your neighbors) throw at them. Their fiberglass windows, for instance, are made from a material that’s stronger than steel and resistant to warping, rotting, or rusting. Meanwhile, Pella’s wood windows combine timeless beauty with modern treatments to resist moisture and decay. It’s like they’re saying, “Bring it on, Mother Nature.”
But Pella doesn’t stop at materials—they test their windows to the extreme. We’re talking hurricane-force winds, driving rain, and even repeated slams (perfect for households with overly enthusiastic window-openers). It’s no wonder they back their products with industry-leading warranties. At Capital Construction, we’ve seen firsthand how Pella windows hold up year after year, proving they’re a smart investment for any home.
